Skip to main content

The official schedule and the Boneyard

Who can do this: Free plan on your first project, Supporter on all projects. Setting the official schedule needs the Approve schedule permission; archiving, restoring, and deleting need Edit schedule.

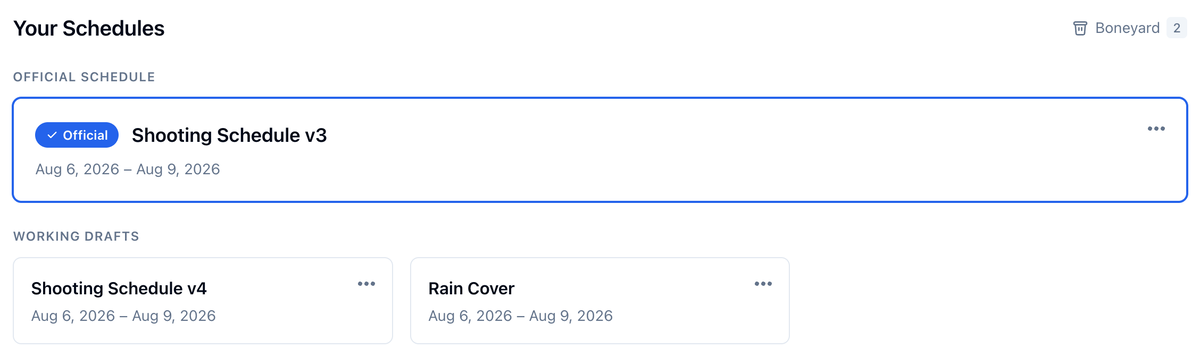

You’ll try the shoot a few ways before you commit: a rain cover, a version with the lighthouse nights first. Mark the one you’re shooting as official, and put the old versions in the Boneyard where they’re out of the way but not gone. In the project nav, click Production, then Schedule. The schedules page: Shooting Schedule v3 marked Official, Shooting Schedule v4 and Rain Cover under Working Drafts, and the Boneyard link with 2 archived schedules

What the official schedule is for

One schedule per project can be official. The rest are working drafts. Spell Slate uses the official schedule for:
  • Call sheets: Production, then Call Sheets, opens the official schedule’s call sheets.
  • Confirm dates requests: actors are asked about their days on the official schedule.
  • The budget: cast work days and hold days come from its Day Out of Days.
  • Reports, shot lists, and day sides: they open on the official schedule’s days.
Without an official schedule, call sheets, the budget, reports, and shot lists use your newest schedule. Confirm dates requests need an official schedule. Day sides do too, unless the project has only one schedule. Being official doesn’t lock a schedule. Keep editing it, and everything above follows your changes.

Make a schedule official

  1. Open the schedule.
  2. Click Set as official and confirm.

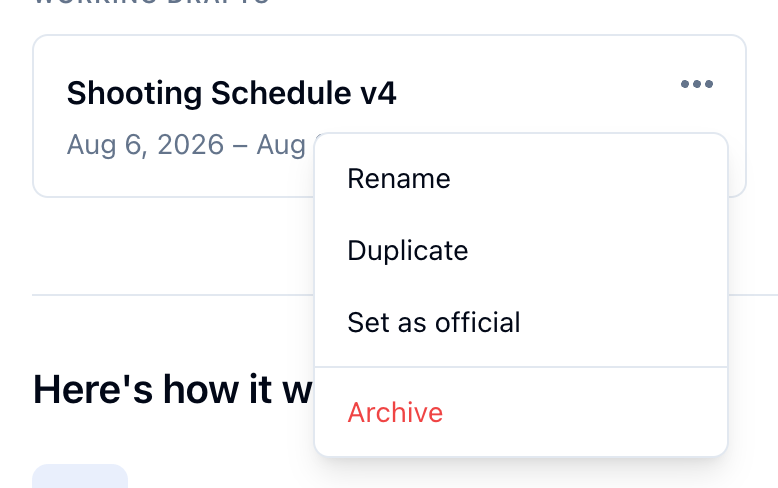

Shooting Schedule v4 changing from a Working draft with Set as official to Official with Make working draft If another schedule was official, it becomes a working draft, and the message names both. You can also click the three dots on a schedule’s card, then Set as official.

Go back to a working draft

Open the official schedule and click Make working draft. The project has no official schedule until you set one.

Try another version

  1. Click the three dots on a schedule’s card.
  2. Click Duplicate.
The menu on Shooting Schedule v4: Rename, Duplicate, Set as official, and Archive The copy has the same strips, day breaks, banners, and DOOD overrides. It starts as a working draft, so the official schedule doesn’t change until you say so. Click Rename in the same menu to give it a name.

Archive a schedule

Click the three dots on the schedule’s card, then Archive, and confirm. It moves to the Boneyard.
  • You can’t archive a project’s only schedule.
  • Archiving the official schedule leaves the project with no official schedule.

Restore or delete a schedule

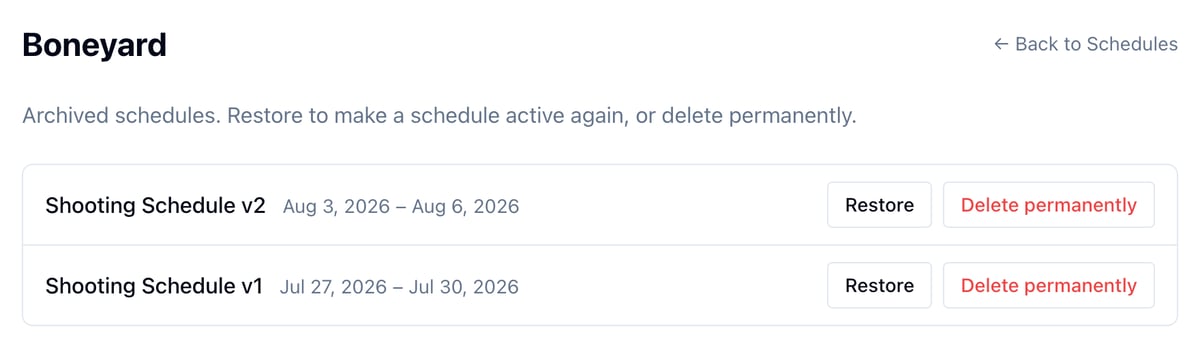

Click Boneyard on the schedules page (or at the top of the schedule sidebar). The Boneyard with Shooting Schedule v2 and v1, each with Restore and Delete permanently
  • Restore brings the schedule back as a working draft.
  • Delete permanently removes it, with its call sheets and Day Bibles. It can’t be undone.
A schedule with a call sheet that was sent to the crew, or with a production report, can’t be deleted. The Boneyard says which day, and the schedule stays there.
